    Weightron Engineers Work ‘Round the Clock’ to Carry Out Difficult Weighbridge Replacement within 48-hour Time Period

    Weightron Admin|22 March, 2023

    Weightron engineers have carried out a challenging weighbridge upgrade at the site of a leading chemical processor, without impacting on the running of the plant. The complex project included the removal of the existing 40-year-old concrete pit weighbridge and the installation of a custom-designed steel replacement that precisely fitted the existing pit foundations.



    The removal and install processes were made more complicated by the fact that the 50 tonne, 15 metre weighbridge is located underneath a large out-loading hopper, which had been constructed after the original weighbridge had been installed.

    The customer had set exacting time restraints on the potential supplier to ensure production at the site was not interrupted. The work, including the calibration and stamping of the new weighbridge, had to be carried out within a strict 48-hour window. This meant having to work ‘round the clock’ for two days to meet the deadline.

    The company’s plant manager is very pleased with the way the project was carried out:

    “Weightron’s planning and expertise ensured the whole project went like clockwork. Their engineers fully understood what was required and how to organize the work involved in the different stages. Any delays would have been expensive for us, but they finished several hours ahead of schedule.”



    Weightron – the only supplier with the all-round capabilities for the challenge

    Weightron were the only supplier who had the all-round capabilities to meet the twin challenges of the tight time restraint and the bespoke nature of the new deck. The company has the engineering skills and manufacturing flexibility to build and install customer-specific weighbridge designs.

    Prior to the installation, Weightron’s engineers worked out a detailed time schedule with the customer to ensure all went according to plan. This involved extensive health and safety considerations, including the drawing up of detailed risk analysis and lift plans, all necessary site inductions and co-ordinated vehicle movement planning.

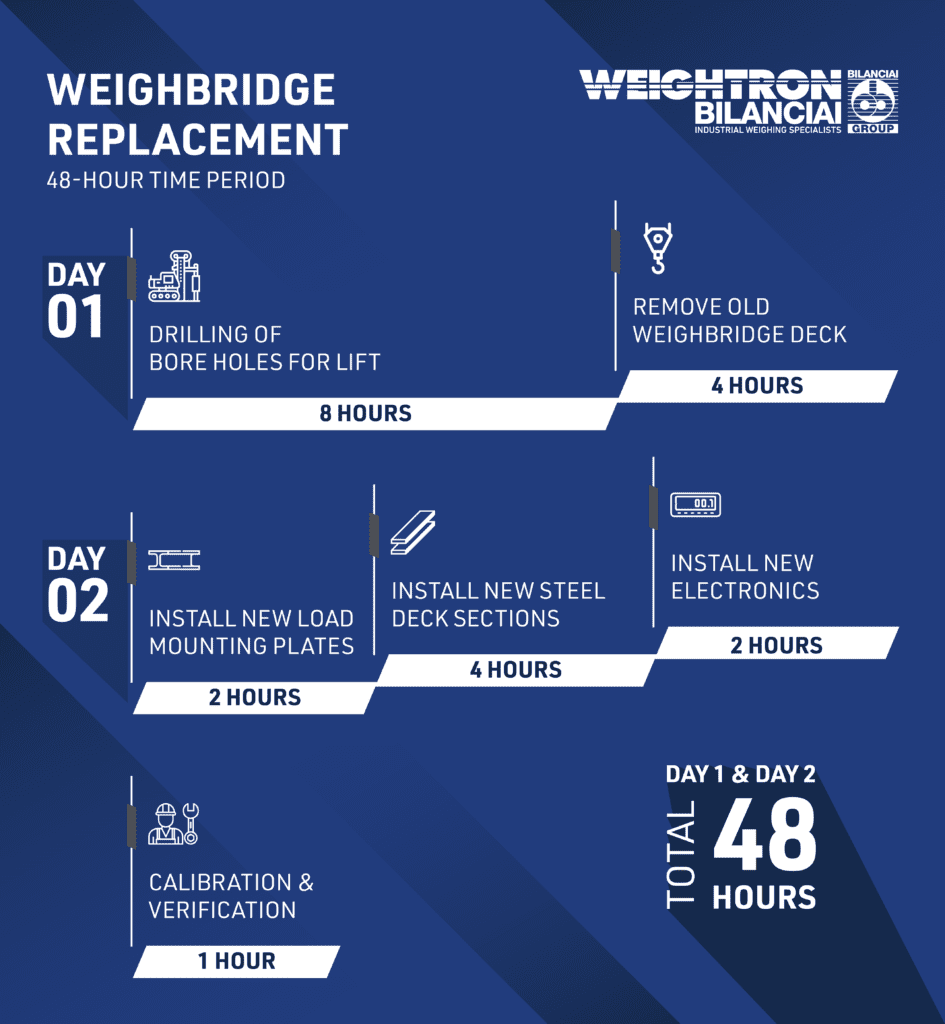

    Starting at midnight on the first day, the engineers’ initial task was to drill holes in the aging concrete deck and fit lifting slings so that the two sections could be safely lifted out and moved to a storage area. The height-restricted access under the hopper meant that the old deck had to be lifted and then slid out using specialist lifting equipment.

    Once the pit was clear, the special load cell mounting plates could be fitted, ready for the new deck. By lunchtime on the second day the new steel deck sections had been lifted into place and the new digital load cells installed. These were then interconnected at the weighbridge junction box and wired back to the weighbridge office, where the new Flynet50 weight indicator and ticket printer are installed.

    By 4-30 PM the weighbridge was ready for Weightron’s calibration truck weighbridge to verify the system and by 6-00 PM the work had been completed and the area handed back to the customer.

    If you are looking to upgrade your current weighbridge, or need a new system, contact our team or find your closest sales manger.

    Download this Case Study as PDF

    Download

    Contact us

      Upload Your CV Below. We Accept The Following File Types: PNG, JPG/JPEG, PDF & DOC/DOCX. Max File Size: 32MB

      Frequently Asked Questions

      What is a Weighbridge?

      A Weighbridge (US truck scale) is a large, low-profile scale used to weigh both road and off-road vehicles (rigid and articulated lorries, dumper trucks, vans etc) and their contents. The load carried by the vehicle is calculated by weighing the vehicle both empty and loaded. The main weighbridge deck structure can be constructed from steel, pre-stressed concrete or steel-concrete composite.

      What is a Pit-Mounted Weighbridge?

      Installed inside a pit, these weighbridges sit flush with the road surface. As they don’t require ramps, they take up less road surface compared to surface mount installations. Suitable for sites with restricted access.

      What is a Surface-Mounted Weighbridge?

      Installed above ground, these weighbridges incorporate steel or concrete ramps to allow vehicles to drive on and off. One advantage is that the ramps slow down vehicle entry speed. Less foundation works are required when compared with pit mount installations. Surface designs are suitable for temporary/portable installations when used with steel ramps.

      Google Rating
      4.9
      Based on 27 reviews
      js_loader
